Home / Tools / Infrastructure Decision Frameworks / Delivery System Architecture

Infrastructure decision framework

Delivery System Architecture

Identify the work, resources, access and authority controlling your next delivery milestone.

Progress does not always move the delivery date

A supplier can finish its own work while the next milestone still waits for a design release, another party's output or site access. Extra effort brings the date forward only if it changes the dependency holding up that milestone.

Trace the controlling dependency

For each required output, record who supplies it, who needs it and what must be available before the work can proceed. Include resources, site access and release authority. Compare proposed interventions across the complete sequence, then recalculate what controls the finish date.

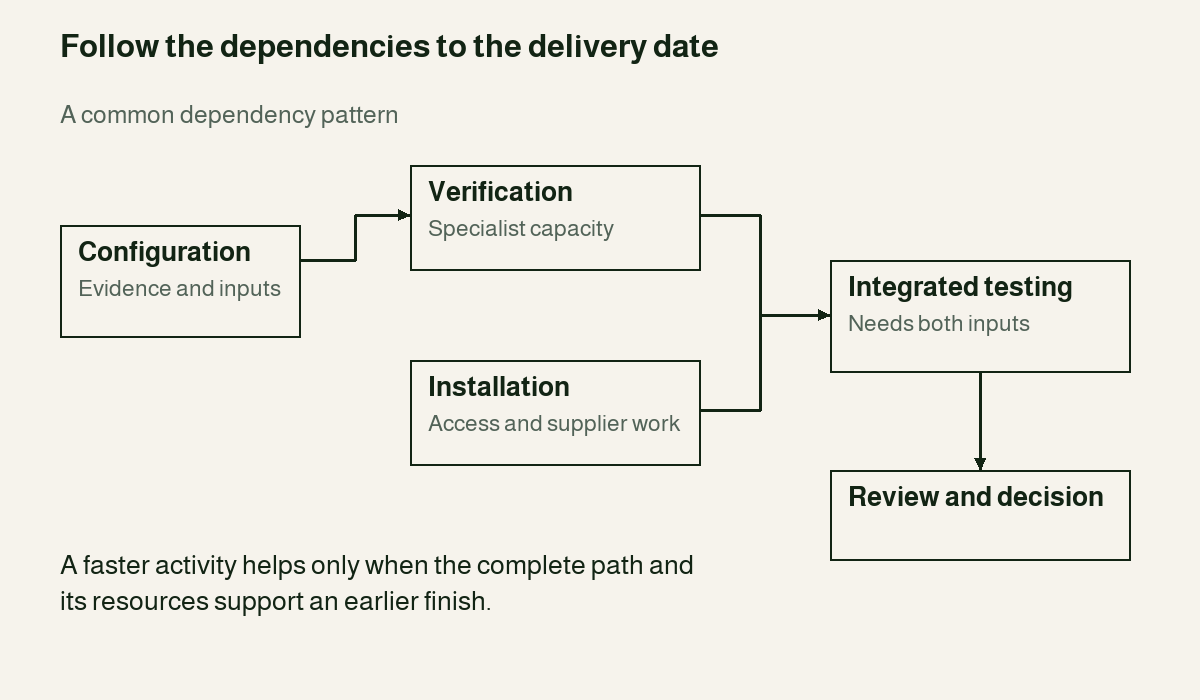

In the illustrated dependency pattern, configuration and specialist capacity support verification. Installation depends on access and supplier work. Verification and installation both feed integrated testing, followed by review and decision.

Configuration feeds verification. Verification and installation both feed integrated testing, followed by review and decision.

Illustrative example.

One intervention changes what controls the plan

The illustrative plan targets working day 25 but finishes on day 37. Verification finishes on day 25 and holds up testing, although installation is complete on day 16.

Two integrators and shorter approval waits bring verification to day 14.5. Installation then controls the start of testing, which runs from day 16 to 19. Acceptance review finishes on day 24.

Illustrative working days. The coordinated arrangement reserves both integrators from day 7 through day 19, including the gap before testing. Added cost is AUD 14,400 for the extra person, AUD 2,000 mobilisation and AUD 3,000 for approval changes; baseline labour is excluded.
Arrangement Forecast finish Additional cost
Current Day 37 AUD 0
Capacity only Day 26.5 AUD 14,600
Authority only Day 33 AUD 3,000
Coordinated Day 24 AUD 19,400
Later access Day 28 AUD 24,200

Map your delivery arrangement

Use the method for delivery planning, procurement, design coordination, mobilisation or recovery where several organisations contribute to a milestone. Work back from the required output. Confirm when each party will provide its work, people or access, and who can authorise the necessary releases.

What you bring

Required output and target date; task outputs, owners and prerequisites; fixed durations or effort and productive capacity; access, resource and release dates; intervention costs and supporting evidence.

What the comparison provides

Task start and finish forecasts, the controlling conditions, days against target, unresolved records and the capacity, access and authority commitments required by the chosen intervention.

Check the arrangement in the detailed programme

The example assumes verification and testing effort can be divided between people. Sequential work, equipment limits, coordination overhead and competing demands can change the result. The map does not optimise resources or simulate schedule uncertainty. Keep tasks in prerequisite order, resolve circular dependencies and confirm the result in the detailed schedule. Technical and operating release remains with the named authority.

Apply the framework

Map the dependencies and compare changes that could bring your next milestone within reach.
